Service · 05

Soil Stabilization Contractors in St. Louis

Soil stabilization is mixing lime or cement into weak, wet or soft soil where it sits, turning it into a firm, workable base for building pads, roads and parking lots. It is the alternative to digging that soil out and trucking in replacement fill, with the stabilizer, rate and depth set by the project's geotechnical mix design. Kuesel is one of the soil stabilization contractors St. Louis GCs, developers and engineers rely on — family-owned in O'Fallon, MO since 1963, with in-house crews and owned equipment.

  • Lime and cement treatment of poor subgrade in place
  • Full depth reclamation of failed pavement
  • Subgrade drying, asphalt pulverization and base stabilization
  • In-house crews and owned equipment — often instead of undercut-and-replace
Get a Bid
Soil Stabilization — Lime and cement stabilization, full-depth reclamation, and subgrade improvement for asphalt contractors and site work in St. Louis.
Choosing a contractor

What a soil stabilization contractor should bring (and what Kuesel self-performs)

  • Builds to the engineer's design
  • Prices stabilization against an undercut alternate
  • Coordinates proof rolls with the GC and the owner's testing agency
  • In-house crews and owned equipment
  • Union labor
Kuesel self-performsBy others
Lime stabilizationQC testing by the owner's testing agency
Cement stabilization—
Subgrade drying—
Base stabilization—
Asphalt pulverization—

Fly ash and cement-modified soil (CMS) are described on this page for reference only; Kuesel does not self-perform them.

Stabilization usually sits inside a larger grading scope; see our work as an excavation contractor in St. Louis.

What we self-perform

Lime, cement, FDR, and subgrade drying — one in-house crew.

Lime stabilization →

Lime is spread and mixed into clay subgrade to the depth and rate the mix design calls for, improving workability and strength.

Cement stabilization →

Cement is spread and mixed into the subgrade where the engineer specifies it, typically for lower-plasticity, silty, or granular soils.

Full-depth reclamation (FDR)

Failed asphalt and its base are pulverized, stabilized, and compacted in place into a new base.

About FDR →

Subgrade drying →

Wet subgrade is treated to dry it out so grading and paving can proceed, subject to conditions and the specification.

Asphalt pulverization

Worn asphalt is ground in place together with the base below it, turning a failed pavement into reusable material. It is the first step of full-depth reclamation, before the stabilizing agent is mixed in and the new base is compacted.

Base stabilization

Lime or cement is mixed into the aggregate or soil base under a parking lot, drive or road to stiffen it and help it resist moisture. The engineer's design sets the agent, rate and depth; we build to it.

Choosing lime or cement

How the stabilizer is chosen

The Federal Highway Administration's Geotechnical Aspects of Pavements manual (section 7.6) gives the usual starting point: lime is generally considered for clay soils with a plasticity index (PI) above about 10 to 12, and cement for lower-plasticity soils.

That rule of thumb is not a design. The stabilizer, application rate and depth come from laboratory mix design testing, as laid out in FHWA's stabilization mix design appendix. The lab work is done for the project engineer or geotechnical engineer; Kuesel follows that mix design in the field. When the choice is between treating the soil and removing it, our guide to lime vs cement vs undercut compares the options.

Methods

Lime, cement, fly ash and cement-modified soil.

Lime stabilization (quicklime)

Lime is generally used on high-plasticity clay — the kind of soil common in the St. Louis area that turns soft and sticky when wet. In the short term it modifies the clay: it dries the soil, lowers the plasticity index and makes it easier to work and compact.

Over the longer term, lime reacts with the clay minerals in a pozzolanic reaction that adds strength. Specifications often call for a mellowing period between initial and final mixing so the lime can work through the clay before the layer is finished.

Cement stabilization

Portland cement hydrates and binds the soil particles together. It is generally suited to low-plasticity, silty or granular soils, and it is commonly the agent used in full-depth reclamation of failed pavement.

Because cement starts to set once it is mixed with water, compaction must be completed within the working time allowed by the specification after mixing. That makes sequencing of spreading, mixing and compaction critical.

Fly-ash stabilization

Class C fly ash is self-cementing and can stabilize soil on its own. Class F fly ash typically needs lime or cement as an activator. Availability varies by region, so the engineer's choice depends partly on what can be supplied for the project.

Cement-modified soil (CMS)

Cement-modified soil uses a lower cement content to improve workability, cut the plasticity index and give the job a working platform. It differs from cement-stabilized subgrade or cement-treated base, which are designed to reach a strength target. Our guide on cement-modified soil vs. cement-treated base covers the difference in more depth.

Modification vs. stabilization

  • Modification improves workability: the soil dries, its plasticity index drops and it can be graded and compacted. It is not counted on for a structural value.
  • Stabilization is designed to reach a strength value — such as unconfined compressive strength, CBR or resilient modulus — that the engineer uses in the pavement or slab design.
  • The same agent can do either. The design intent, application rate and testing decide which one the spec is asking for.

Kuesel self-performs lime and cement stabilization and FDR. Fly ash and CMS are described so the options in a spec are clear.

When to use each

Match the method to the soil and the goal.

OptionSoil type / PIPrimary goalTypical useNotes
LimeHigh-plasticity clays (higher PI)Dry and modify the clay, then long-term strength gainBuilding pads, pavement subgrade and wet clay that fails proof rollOften specified with a mellowing period between initial and final mixing
CementLow-plasticity, silty or granular soilsBind the soil into a stiffer, stronger layerPavement subgrade, base stabilization and FDRCompaction must be completed within the spec's working time after mixing
Fly ashVaries; set by the mix designSelf-cementing (Class C) or activated with lime or cement (Class F)Where specified and locally availableRegional availability varies
Cement-modified soil (CMS)Soils that need workability improvementWorking platform and lower plasticity, not a strength targetConstruction platforms and subgrade that must be workableLower cement content than a strength-designed layer
Undercut and replaceAny soil the engineer rejectsRemove unsuitable soil and replace it with approved materialDeep soft zones, unsuitable fill, or where treatment is not specifiedNeeds haul-off, a disposal site and import material

Stabilize in place, or undercut and replace?

FactorIn-place stabilizationUndercut & replace
What happensExisting soil is treated in place with the specified stabilizing agentPoor soil is excavated, hauled off, and replaced with imported material
ScheduleNo haul-off and import cycle; treated in sequence with gradingDepends on haul distance, disposal site, and import availability
TruckingDeliveries of stabilizing agentTrucks out with spoils, trucks in with fill or rock
WeatherCan dry wet subgrade; application still limited by conditions and the specOpen excavations and wet import can sit idle after rain
SpoilsNone generated from the treated zoneExcavated soil needs a disposal site

We price both so you can compare. These are general tendencies, not a design. Read the full comparison in Lime vs. Cement vs. Undercut, or run your numbers in the stabilization vs. undercut tool. For lighter treatments, see cement-modified soil vs. cement-treated base.

Specs, geotech & proof rolls

The engineer of record governs; the owner's agency tests.

  • The geotechnical engineer of record and the lab mix design govern the stabilizing agent, application rate and treatment depth. We build to that design.
  • In Missouri, MoDOT's Standard Specifications for Highway Construction govern MoDOT work, and project specifications on other work often reference them.
  • Typical verification includes field density and moisture testing, depth and pulverization checks, and proof rolling. Quality-control testing is performed by the testing agency retained by the owner, not by Kuesel.
  • Sulfate-bearing soils can heave when treated with calcium-based stabilizers such as lime or cement, so sulfate testing should be considered when the specification calls for it.
  • Weather limits apply: most specifications restrict work in freezing temperatures and high wind, and require the treated layer to be protected while it cures.

We coordinate proof rolling and test timing with the owner's testing agency and the general contractor. See proof rolling and failed proof roll fixes.

Our process

From geotech report to tested subgrade.

  1. 1Geotech review and mix design
  2. 2Scarify and pre-pulverize the subgrade
  3. 3Spread the agent at the design rate, with dust control
  4. 4Mix to depth with a reclaimer / stabilizer
  5. 5Add water to the target moisture
  6. 6Compact
  7. 7Fine grade
  8. 8Cure or seal
  9. 9Test and proof roll before paving or slab
Equipment

Owned equipment, in-house crews.

  • Spreader trucks

    Spread lime or cement across the subgrade at the rate set by the mix design.

  • Reclaimer / mixer

    Mixes the agent into the soil to the specified depth, and pulverizes pavement and base on FDR work.

  • Compaction equipment

    Compacts the treated layer after mixing and moisture conditioning.

  • Grading equipment

    Fine grades the treated subgrade to the elevations on the plans.

  • Water trucks

    Bring the mixed soil to the target moisture and help control dust.

Lime spread on subgrade ahead of mixingReclaimer mixing stabilized subgradeSpreader trucks on a cement stabilization jobStabilized roadway subgrade beside an unstabilized section
Who it's for

GCs, owners and engineers.

General contractors on hard-bid work

Send the ITB, plans and geotech. We price stabilization to the spec, and undercut as an alternate when you want the comparison, then schedule proof rolls and testing around your paving or slab sub.

For general contractors →

Owners and developers

When soft clay threatens a pad or parking lot budget, an early look at stabilization against undercut can keep material on site and the schedule intact.

For developers →

Engineers

We read stabilization specs from the field side and can give early budget pricing for stabilization vs. undercut while you design. The design decisions stay yours.

For engineers →
What engineers should send us

Send these and we can price it.

  • Geotech report
  • Borings and PI (plasticity index) data
  • Plan sheets
  • Specified depth and strength targets
  • Quantities

Working on a spec? See our page for civil & geotechnical engineers.

Industry involvement

Recycling & reclaiming associations

  • Asphalt Recycling and Reclaiming Association (ARRA)
  • Pavement Recycling and Reclaiming Center Founders Circle
  • National Road Research Alliance (NRRA)
  • Pavement Preservation and Recycling Alliance (PPRA)
  • National Asphalt Pavement Association (NAPA)
Stabilization projects

Featured project: Tire plant Phase II, Clarksville, TN

On Phase II, Kuesel lime-stabilized 327,817 SY under the building pad, pavements, rail spur and laydown yards using about 10,300 tons of lime, at three different depths and rates on a pad with deep equipment pits cut inside it.

See the Clarksville tire plant project →
Stabilization projects on the record
ProjectClient typeLocationAgentArea / depthOutcome
Tire Plant Phase IIIndustrial (tire plant)Clarksville, TNLime, about 10,300 tons327,817 SY — building pad 16" at 5%; pavements and rail spur 12" at 4%; laydown yards 12" at 3%Building pad lime-stabilized at three different depths and rates, with deep equipment pits cut inside the pad.
Retail Pavement Cement StabilizationNational retail storeAlton, IL (Madison County)Portland cement at 7%About 4,300 SY at a 12-inch depthSubgrade treated in place instead of undercut, so paving could follow.
University Track & Soccer UpgradeUniversity athleticsColumbia, MOPortland cementStabilized to a 12-inch depthSoil stabilization subcontractor with union labor; compaction by others.
West Plains Baseball/Softball Field (2024)School athletics fieldWest Plains, MOQuicklime at 2.5%11,235 SY at a 12-inch depthQuicklime subgrade stabilization, spread, mixed and watered by Kuesel.
University City, MO cement-stabilized base (2023)Available on requestUniversity City, MOPortland cement at 4%1,148 SY at a 12-inch depth (existing aggregate base)Existing aggregate base cement-stabilized in place, with the subgrade restored to ±0.10 ft.

More stabilization project references are available on request.

Guides

Stabilization guides.

Soil stabilization FAQ

Questions engineers and GCs ask.

What is soil stabilization?

Soil stabilization is mixing lime or cement into weak, wet or soft soil where it sits, so it becomes a firm, workable base for a building pad, road or parking lot instead of being dug out and replaced. A soil stabilization contractor spreads and mixes the stabilizer to the agent, rate and depth set by the geotechnical engineer's mix design, then compacts and grades it so paving or a slab can follow. Kuesel, a family-owned St. Louis site contractor in O'Fallon, MO since 1963, self-performs lime and cement stabilization, subgrade drying and base stabilization with in-house crews and owned equipment. Quality-control testing is done by the owner's testing agency.

Lime vs. cement: which does my site need?

As a general guide, the Federal Highway Administration's Geotechnical Aspects of Pavements manual (section 7.6) says lime should be considered for clay soils with a plasticity index above about 10 to 12, while cement is more commonly used on lower-plasticity soils. The final choice, application rate and depth come from laboratory mix design testing, described in FHWA's mix design appendix. We follow the project engineer's or geotechnical engineer's mix design; we do not run the lab.

What affects the cost of soil stabilization?

The main factors are the area to be treated, the treatment depth, the stabilizer type and application rate set by the mix design, how wet the soil is, site access, and the testing the specification requires. We price each job from the plans, geotech report and mix design, and can price an undercut alternate alongside it. Our guide to soil stabilization cost factors covers each one.

Can you stabilize soil in cold or wet weather?

Wet soil is one of the most common reasons to stabilize: lime and cement dry out soft, wet subgrade so grading and paving can continue instead of waiting for it to dry on its own. Cold weather is different. FHWA's Soil and Base Stabilization manual (Volume II, mixture design) advises that lime-cement stabilization should not be attempted when the soil temperature is below 40°F. Most specifications also restrict work in high wind and require the treated layer to be protected while it cures.

Stabilize or undercut?

Where the engineer approves it, stabilizing soil in place avoids hauling soft soil off site and importing replacement fill, which cuts trucking and spoils. Undercut can still be the right call for deep soft zones or unsuitable fill. We price both so GCs and developers can compare them; our lime vs. cement vs. undercut guide walks through the trade-offs, and the stabilization vs. undercut tool compares cost, schedule and trucks for a specific site.

What about dust?

Kuesel spreads lime and cement dust-free from its own state-of-the-art spreader trucks. We also follow the specification's wind limits, use water trucks, and mix the agent in promptly after it is spread. Occupied or sensitive sites get a spreading plan agreed with the GC in advance.

Have a geotech report? Send it over.

Send the ITB, plans and geotech report and we'll price it.

Request a bid

Negotiated or design-assist?

Bring us in before the spec is locked.

Talk to us early on a negotiated or design-assist project
Ground stabilization

Soil and ground stabilization services in St. Louis

As a soil stabilization company, Kuesel provides ground stabilization with lime and cement treatment, subgrade drying, base stabilization and full depth reclamation of existing pavement. Our in-house crews use the methods specified by the geotechnical engineer and lab mix design for building pads, drives and parking lots. Our soil stabilization service is often one step in our wider commercial site work: the same company grades the pad as your earthwork contractor and installs the storm, sanitary and water lines as a site utility contractor.

What's Included

Capabilities under this service line

  • Lime stabilization
  • Cement stabilization
  • Full-depth reclamation (FDR)
  • Subgrade drying
  • Geogrid & geotextile install
  • Proof rolling with the GC and the owner's testing agency
On the Job

Soil Stabilization in action

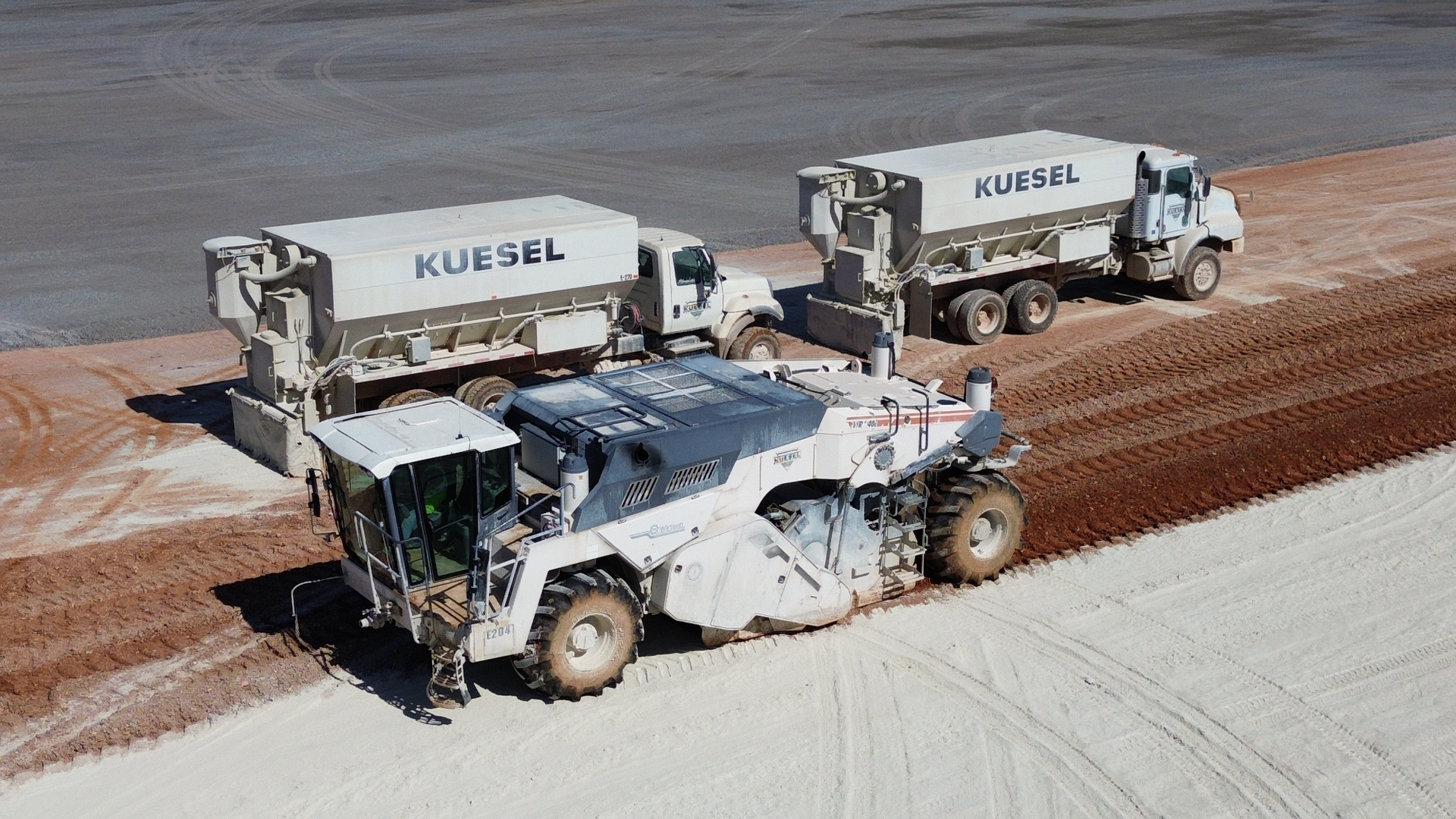

Spreader trucks placing stabilization agent on subgrade
Wirtgen reclaimer performing full-depth reclamation on a roadway
Water truck supporting full-depth reclamation operations
Lime spread on subgrade ahead of mixing
Spreader trucks on a cement stabilization job
Reclaimer mixing stabilized subgrade
Kuesel crew mixing and compacting cement-stabilized subgrade with a water truck, Wirtgen reclaimer, roller and dozer in Bridgeton, MO
Cement soil stabilization in Bridgeton, MO: mixing and compaction on the same pad.
Why Kuesel

Three reasons
not the other guys.

Talk to Preconstruction
  • 01Lime, cement, and full-depth reclamation (FDR) under one in-house crew
  • 02Built for Missouri clay — road bases and building pads that don't move
  • 03Proof rolling with the GC and the owner's testing agency before treatment
Since 1963
Self-performing
Operating Engineers Local 513 · Laborers Locals 110/42/660 · Teamsters · Plumbers & Pipefitters UA Local 562
Union signatory
6 self-perform
Service lines under one roof
St. Louis & Surrounding Areas
Licensed
300+ pieces
Late-model fleet
1 business day
Bid response
Who We Build This For

Soil Stabilization for the owners and GCs that hire Kuesel

See how this scope plugs into the verticals we serve across St. Louis, Missouri, and Illinois:

Browse the full Who We Serve page for every market Kuesel partners with.

Call (636) 978-3478
